The Real Timeline: How Long Does It Actually Take to Build a Pool in The Woodlands?
- chad454
- 1 day ago
- 6 min read
If you've been thinking about building a pool in The Woodlands, you've probably wondered the same thing every homeowner asks: How long is this actually going to take?
It's a fair question. And honestly, the answers you find online are all over the place. Some builders promise impossibly fast turnarounds. Others give such wide ranges that they're practically useless. You deserve a straight answer, especially if you're hoping to be swimming by summer.
So let's break it down. The real timeline. The phases you'll go through. And what makes building a pool in The Woodlands area may be a little different from other parts of Texas.
The Honest Answer
For most custom pools in Spring to Conroe corridor, you're looking at 8 to 12 weeks from the first dig to completion. That's the construction phase alone.
When you factor in design and permitting? A more realistic total timeline is 10 to 16 weeks from your first consultation to diving in.
That might sound like a lot. But here's the good news: if you start the process now, late January, you're in an excellent position to be pool-ready by late May or early June. Right when the Texas heat really kicks in.
The key is understanding what happens during each phase, so you're not caught off guard by delays that are actually pretty normal.

Phase 1: Discovery & Design (1-2 Weeks)
This is where the fun begins. You'll sit down with your builder to talk through what you actually want. Not just the shape and size, but how you envision using the space. Do you want a tanning ledge for lazy Sunday afternoons? A deep end for diving? A spa attached for year-round relaxation?
A good builder will ask questions you haven't even thought of yet. They'll consider your backyard's layout, drainage, existing landscaping, and how the pool will flow with your outdoor living space.
During this phase, you'll typically see your pool come to life through 3D renderings. It's one thing to look at a flat blueprint. It's another to see a realistic visualization of your future backyard. This step helps you make confident decisions before a single shovel hits the ground.
Design usually takes one to two weeks, depending on how quickly you finalize your choices. The more decisive you are, the faster this phase moves.
Phase 2: Permitting (2-4 Weeks)
Here's where The Woodlands gets a little... unique.
If you live within The Woodlands Township or one of the surrounding communities in Montgomery County, you're dealing with a permitting process that requires some patience. Between township approvals, county permits, and HOA reviews, there are multiple layers to navigate.
The Woodlands is known for being particular about aesthetics and community standards. That's part of what makes it such a desirable place to live. But it also means your pool plans need to meet specific guidelines before construction can begin.
Expect this phase to take two to four weeks on average. In some cases, especially in communities with stricter Residential Design Review Committee, it can stretch longer.
The good news? An experienced local builder knows exactly what The Woodlands Township and Montgomery County require. They'll submit everything correctly the first time, avoiding the back-and-forth that causes unnecessary delays.

Phase 3: Construction (5-10 Weeks)
Once permits are approved, the real work begins. Construction typically unfolds in several stages:
Once permits are approved, the real work begins. And if you want a clean, durable, high-end result, the build is a sequence. Not a scramble. Here’s the 11-step flow we follow so you can see why a quality build typically lands in that 6-10 week window.
1. Design Review Meeting (Finalizing details)
Before anything starts, you and your builder do a final review. This is where you lock in the details: finishes, equipment, elevations, drain locations, lighting, and any feature add-ons. It’s not about overthinking. It’s about building it right the first time.
2. Excavation (The dig)
This is the “wow, it’s happening” moment. The layout is marked, the pool is dug to depth, and soil is hauled out. It’s fast, messy, and necessary.

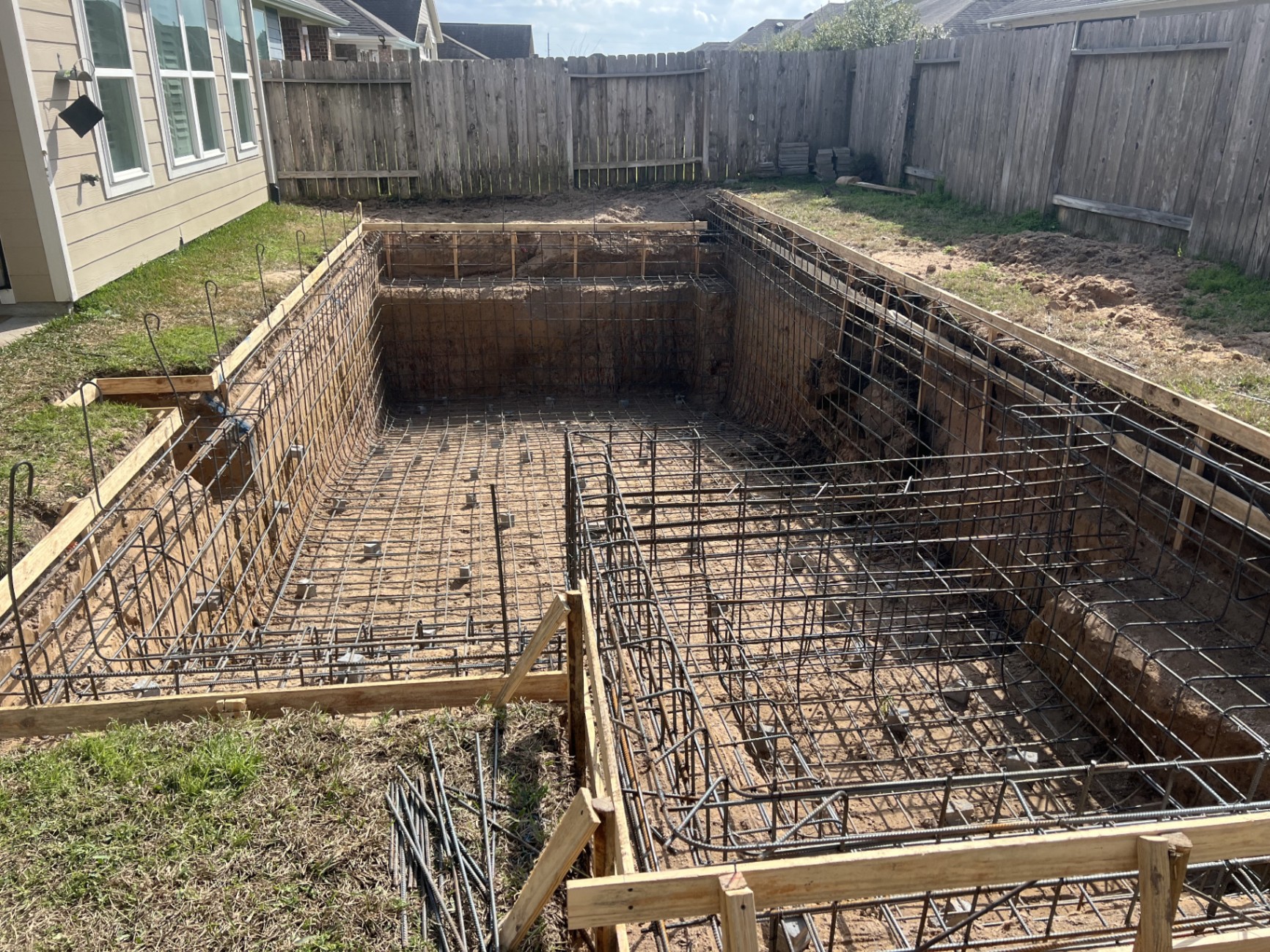

3. Rebar (Steel skeleton)
Next comes the steel. Rebar is installed and tied together to match the engineering plan, creating the structural cage that gives the pool its long-term strength. This is a big part of what separates a pool that holds up for decades from one that starts cracking early.
4. Stub out (Initial plumbing/electric)
Now the basics get roughed in. Plumbing lines are stubbed out for things like skimmers, returns, and water features, and initial electrical is prepped for lights and equipment. Think of it as the “rough draft” that gets everything positioned correctly before the shell goes in.
5. Gunite (The shell - needs 7-10 days to cure)
Gunite is sprayed over the steel to form the concrete shell. Then it needs 7 to 10 days to cure. This is the part you don’t rush. Cure time is where durability is earned.
6. Cleanup (Prepping the site)
After gunite, the site gets cleaned up and prepped for the next trades. It’s not glamorous, but it keeps the project moving smoothly and helps prevent little issues from stacking into bigger delays.
7. Plumbing & Electrical (The 'guts' of the pool)
This is where the systems get dialed in. Plumbing is finalized, pressure-tested, and routed to the equipment pad. Electrical is run for pumps, heaters, lights, and automation. It’s the behind-the-scenes work that makes the pool easy to own, not just nice to look at.

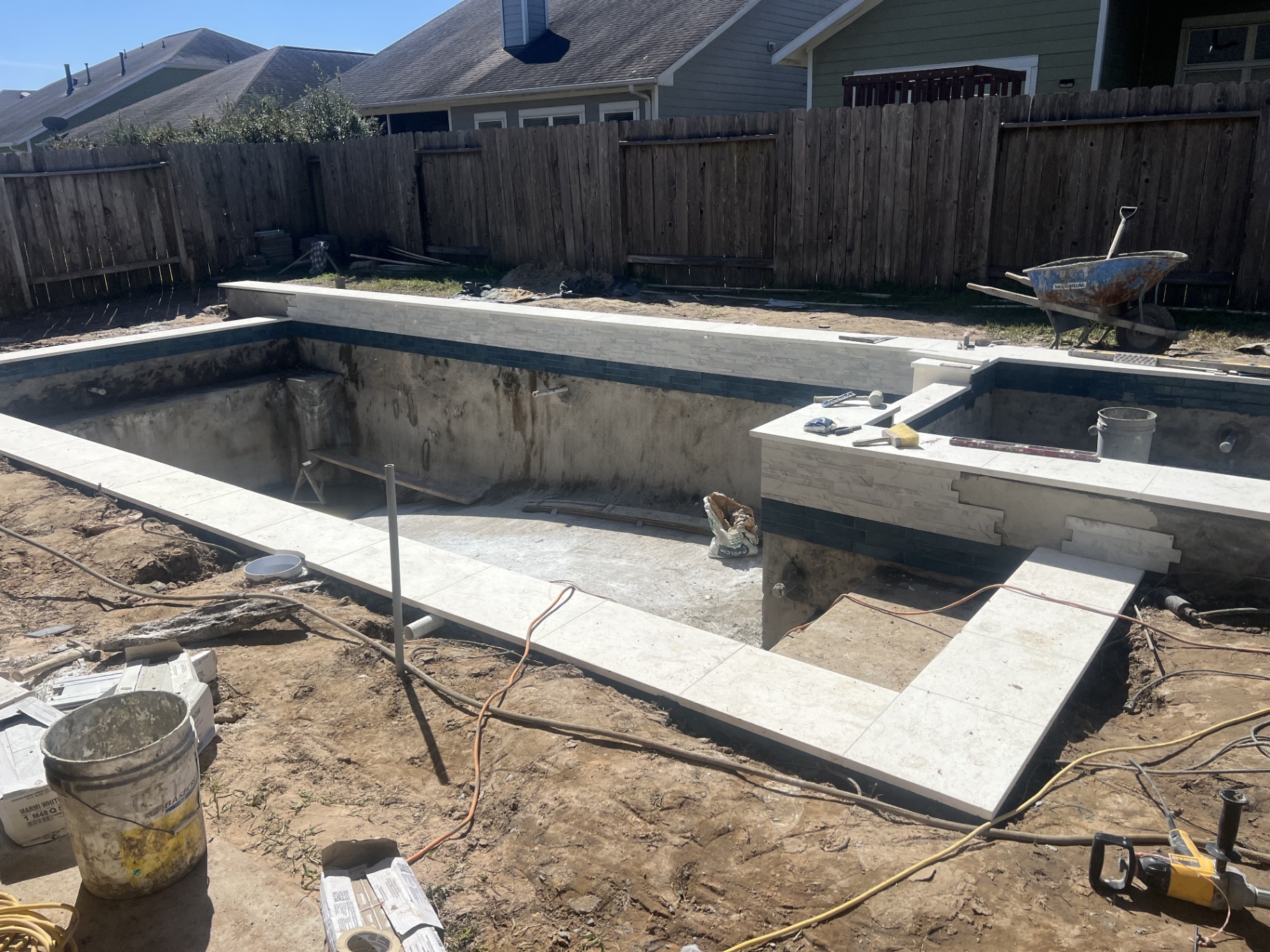

8. Tile & Coping (Aesthetics and edges)
Now the pool starts looking finished. Waterline tile goes in, and coping is installed around the edge. This step has to be clean and consistent because it’s what you’ll see up close every day.

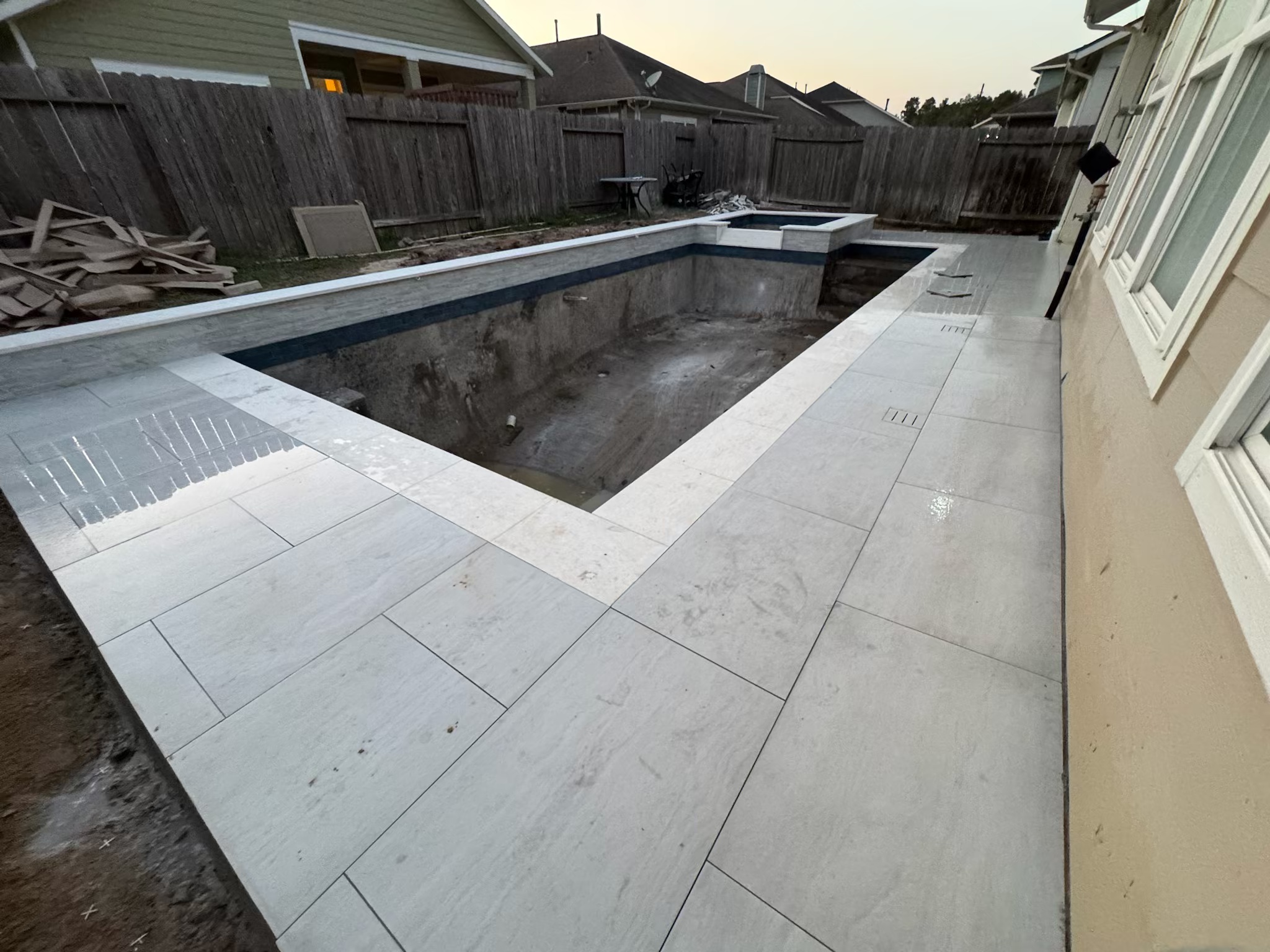

9. Decking (Your new patio space)
Your deck (patio) goes in next. This includes forming, pouring, finishing, and any specialty surfaces like porcelain pavers or natural stone. It can move quickly, but it still needs proper prep and cure time.
10. Plaster (The interior finish)
Plaster (or pebble, quartz, etc.) is applied as the interior finish. This is one of the last major steps, and it’s a detail step. The look, feel, and longevity of the pool surface depends on doing it carefully.
11. Startup (Filling and balancing)
Finally, the pool is filled and started up. Equipment is tested, water chemistry is balanced, and everything is calibrated so your pool runs the way it should from day one.
When you see it broken down like this, the timeline makes sense. It’s not about going slow. It’s about not cutting corners on the steps that actually matter.
What Can Affect Your Timeline?
Even with the best planning, a few factors can shift your schedule:
Weather. Texas weather is unpredictable. Heavy rain can delay excavation and plaster work. A few rainy days here and there won't derail the project, but extended wet periods can push things back.
Design Approvals. Some communities in The Woodlands area have notoriously thorough review processes. If your design includes features that require additional approval - like a water feature visible from the street or fencing modifications - build in extra time.
Design Changes. If you change your mind mid-project, that's okay, but it will add time. The cleaner your decisions are upfront, the smoother construction goes.

Why Starting Now Makes Sense
Late January might feel early to think about summer. But if you want to be swimming when temperatures hit the 90s, now is the ideal time to begin.
Here's the math:
Design & Consultation: 1-2 weeks
Permitting: 1-4 weeks
Construction: 6-10 weeks
That puts you at roughly 8-16 weeks total. Starting now means you're looking at a completion date somewhere between late April and early June.
That's not cutting it close. That's planning ahead.
There's also something to be said for the mental benefit of getting started. Instead of spending the next few months wondering should we do this?, you'll be watching your backyard transform. By the time your neighbors are just starting to think about pools, you'll be hosting the first barbecue of the season.
A Note About The Woodlands Area
We work throughout The Woodlands, Conroe, Tomball, Magnolia, and surrounding communities. Each area has its own permitting quirks and HOA considerations. What stays consistent is our approach: we help you with the paperwork and keep you informed every step of the way.
If you're curious about what past projects have looked like, you can browse our portfolio to see a range of pools we've built for families in the area.
Ready to Start the Conversation?
Building a pool is a significant investment, not just financially, but in your lifestyle. It changes how you spend weekends, how you entertain, and how your family connects.
The timeline doesn't have to be a mystery. With a clear plan and a builder who knows The Woodlands area inside and out, you can move from idea to reality without the stress.
Summer will be here before you know it. The only question is whether you'll be ready for it.
